If you're responsible for a commercial building, residential block, or any premises where people gather, emergency lighting testing regulations UK law requires you to follow aren't optional, they're a legal obligation. Failure to comply can result in enforcement action, fines, or worse, a situation where people can't safely exit a building during a power failure.
The core standard governing this area is BS 5266-1, which sets out exactly how emergency lighting systems should be tested, how often, and what records you need to keep. It works alongside the Regulatory Reform (Fire Safety) Order 2005, placing the duty squarely on the "responsible person", typically the building owner, landlord, or facilities manager.
At Electrical Testing London, our engineers carry out emergency lighting testing across London and the South East for landlords, commercial property owners, and managing agents. We see first-hand how often systems fall short of compliance, sometimes because the testing schedule has lapsed, sometimes because nobody was clear on what the regulations actually require.
This guide breaks down BS 5266-1 in plain terms: what tests you need, how frequently they must happen, who's responsible, and what proper documentation looks like.
Emergency lighting exists for one reason: to guide people safely out of a building when the mains power fails. Whether the cause is a fire, an electrical fault, or an unplanned outage, your system needs to activate immediately and remain operational long enough for every occupant to reach a place of safety. Many systems look perfectly fine during normal daily operation, only to fall short the moment they're actually needed. Regular testing is the only reliable way to confirm your system will perform when it matters.
When emergency lighting fails during an actual emergency, the consequences move quickly from inconvenient to dangerous. Occupants who are unfamiliar with a building, such as hotel guests, office visitors, or patients in a care home, rely entirely on lit exit routes and signage to navigate to safety. Without working emergency lights, corridors go dark, stairwells become hazardous, and evacuation slows dramatically. The risk of serious injury or death rises significantly in those conditions.
A system that appears intact during normal operation can still fail completely the moment mains power drops. Only scheduled testing reveals that before an emergency does.
Beyond the physical danger, non-compliance with emergency lighting testing regulations UK law sets out carries direct legal and financial consequences. Under the Regulatory Reform (Fire Safety) Order 2005, the responsible person can face serious penalties if a fire authority inspection uncovers missing records or a poorly maintained system. Your insurer may also void a claim if the installation was not maintained to BS 5266-1 standards.
Penalties a responsible person can face include:

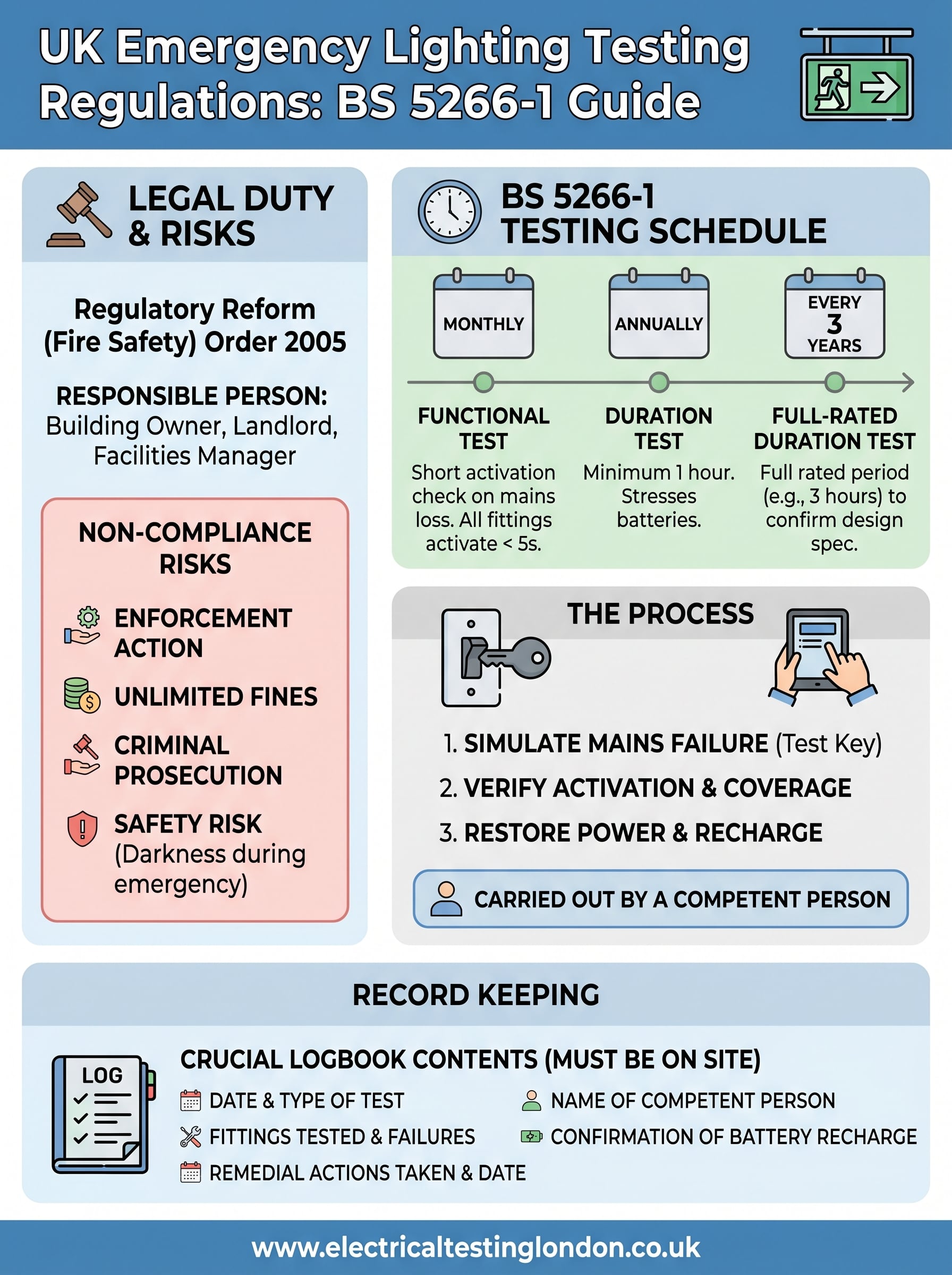

Two key pieces of legislation and guidance shape emergency lighting testing regulations UK property managers must follow. BS 5266-1:2016 is the British Standard that sets out the technical requirements for emergency lighting systems, covering design, installation, and testing. The Regulatory Reform (Fire Safety) Order 2005 creates the legal duty, requiring the responsible person to carry out and document regular fire safety measures, including emergency lighting.
BS 5266-1 defines three types of tests you must carry out: a monthly functional test, an annual one-hour duration test, and a three-year full-rated-duration test lasting the full rated period. Each test checks whether the system activates correctly when mains power is interrupted and holds charge long enough to support safe evacuation.

BS 5266-1 does not offer flexibility on testing intervals. The schedule is fixed, and your documentation must reflect it accurately.
The Regulatory Reform (Fire Safety) Order 2005 places the obligation on the "responsible person", typically the building owner, landlord, employer, or facilities manager. You are required to ensure the system is maintained, tested on schedule, and that a logbook is kept recording every test result. Local fire authorities can inspect at any time and request those records on the spot.
Testing emergency lighting correctly means more than flicking a switch. You need to interrupt the mains supply to each fitting using the dedicated test key or by operating a test switch, then verify that every luminaire and exit sign activates within five seconds and remains lit for the required duration. This process should always be carried out by a competent person who understands the system layout and knows how to log results accurately.
Never test emergency lighting without notifying building occupants first, as unexpected darkness in occupied areas creates an immediate safety risk.
Before you begin, confirm that your test schedule aligns with BS 5266-1 requirements for the type of test you are carrying out. Then work through each circuit methodically, using the test key to simulate a mains failure. Check that all fittings illuminate, that coverage reaches the required areas, and that no units show visible damage or signs of deterioration.

After completing the test, restore power and allow batteries to recharge fully before the next test period, typically over 24 hours. Log the date, duration, any failed units, and the name of the person who carried out the work. If a fitting fails, it needs remedial attention before it can be recorded as compliant. This process sits at the core of meeting emergency lighting testing regulations UK buildings must observe.
BS 5266-1 sets out three distinct testing intervals, and missing any one of them puts your premises out of compliance. Understanding what each test involves and how long it takes helps you plan your maintenance schedule accurately and avoid gaps that a fire authority inspection would immediately flag.
Getting the frequency right from the start means you never reach an inspection with overdue tests on your record.
The table below lays out what BS 5266-1 requires across all three testing intervals. Use it as a direct reference when you build your compliance schedule, so every required test is accounted for across the year.
| Test type | Frequency | Duration |
|---|---|---|
| Functional test | Monthly | Short activation check on mains loss |
| Duration test | Annually | 1 hour minimum |
| Full-rated duration test | Every 3 years | Full rated period (typically 3 hours) |
Each test within the emergency lighting testing regulations UK framework builds on the previous one. Monthly checks confirm your fittings activate correctly on mains loss; the annual test stresses the batteries for a sustained period; and the three-year test runs the system to its complete rated duration to confirm it genuinely meets the original design specification set at installation.
Your logbook is the physical proof that you've met the requirements set out in emergency lighting testing regulations UK property owners must follow. Without it, even a perfectly maintained system can leave you unable to demonstrate compliance to a fire authority inspector. The logbook must be kept on site and updated after every test.
If your records are incomplete or out of date, an inspector will treat your system as non-compliant regardless of its physical condition.
Every logbook entry needs to capture the date of the test, the type of test carried out, any fittings that failed, and the name of the competent person who performed the work. Keep remedial records alongside test logs so you can show that faults were identified and resolved promptly.
Each entry should include:
The most frequent issues our engineers uncover include battery degradation in older fittings, missing monthly records, and fittings never added to the log after installation. Letting your annual duration test lapse creates a compliance gap that is difficult to explain to a fire authority inspector.

If your emergency lighting system hasn't been tested recently, or your logbook has gaps, now is the time to act. Emergency lighting testing regulations UK law are not guidelines you can defer, they're mandatory requirements with real legal consequences attached. Start by checking your last test date against the BS 5266-1 schedule and identify which tests are overdue.
From there, appoint a competent person to carry out your outstanding tests and get your logbook updated with accurate records. If your system hasn't had a three-year full-rated duration test, that should be your immediate priority alongside any outstanding monthly or annual checks.
Electrical Testing London carries out emergency lighting testing across London and the South East for landlords, commercial property owners, and managing agents. Our engineers will test, document, and advise on any remedial work needed to bring your system into full compliance. Get a quote for emergency lighting testing and make sure your records are in order.
